What is change control in project management?

Sneha Kanojia
14 Jan, 2026
Managing project changes effectively, shown as a simple flow from change request to impact analysis and approval decision.

Introduction

Change is part of every modern project, whether driven by customer feedback, technical discovery, or shifting business priorities. What separates high-performing teams from chaotic ones is how those changes get handled. Change control in project management gives teams a clear way to evaluate, approve, and track changes without breaking delivery plans. Instead of letting scope drift quietly, a strong change control process makes every change visible, intentional, and connected to real work. In this guide, we will explain what project change control means today, how it works in practice, and how teams can use it to keep projects predictable while still staying flexible.

What is change control in project management?

Change control in project management is the system teams use to handle changes in a structured way. It ensures that every change to a project is captured, reviewed, and decided on before work moves forward. Instead of allowing updates to occur through chats or side agreements, project change control establishes a single, clear path for approving or rejecting changes. This protects teams from hidden scope growth, missed deadlines, and budget surprises while still allowing projects to adapt when needed.

What a project baseline is

A project baseline is the agreed starting point for how a project will be delivered. It includes four core elements:

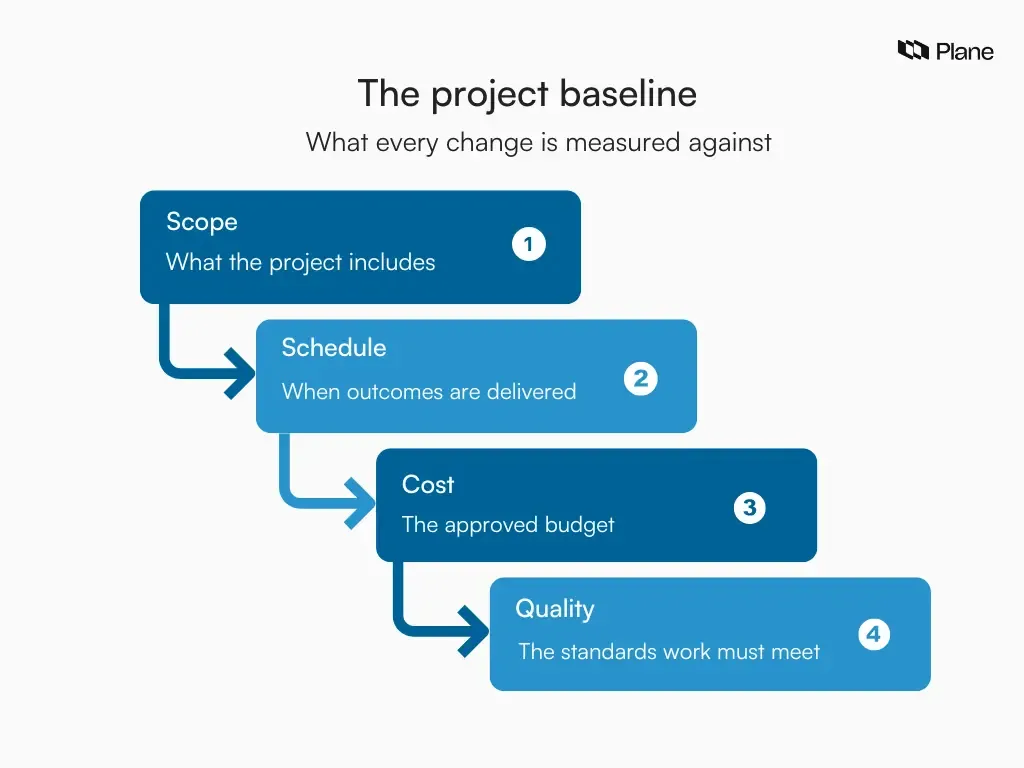

Diagram showing a project baseline made up of scope, schedule, cost, and quality, used as the reference point for change control in project management.

  • The scope, which defines what will be built;
  • The schedule, which shows when it will be delivered.
  • The cost, which reflects the budget;
  • The quality standards, which describe how good the final result must be.

Together, these form the reference point against which everyone plans. The baseline is what makes it possible to say whether a project is on track or drifting.

Why every change must be reviewed against the baseline

Any change that affects scope, schedule, cost, or quality also changes the baseline. A new feature request, a deadline shift, or a resource change all move the project away from its original plan. The change control process exists to make these shifts visible and deliberate. By reviewing each change request against the baseline, teams understand what they gain, what they give up, and how the project will be affected before they commit.

How change control protects project delivery

Without a change control system, projects absorb changes in small pieces that add up to major disruption. Integrated change control keeps the project aligned by recording every approved change and updating the baseline to match reality. This gives teams a single source of truth for what the project now includes, how long it will take, and what it will cost. With that clarity, teams can make decisions with confidence instead of reacting to surprises later.

What counts as a change?

A change control process only works when teams agree on what actually counts as a change. When this is unclear, teams either send everything for approval or let important updates slip through without review. Both lead to delivery problems.

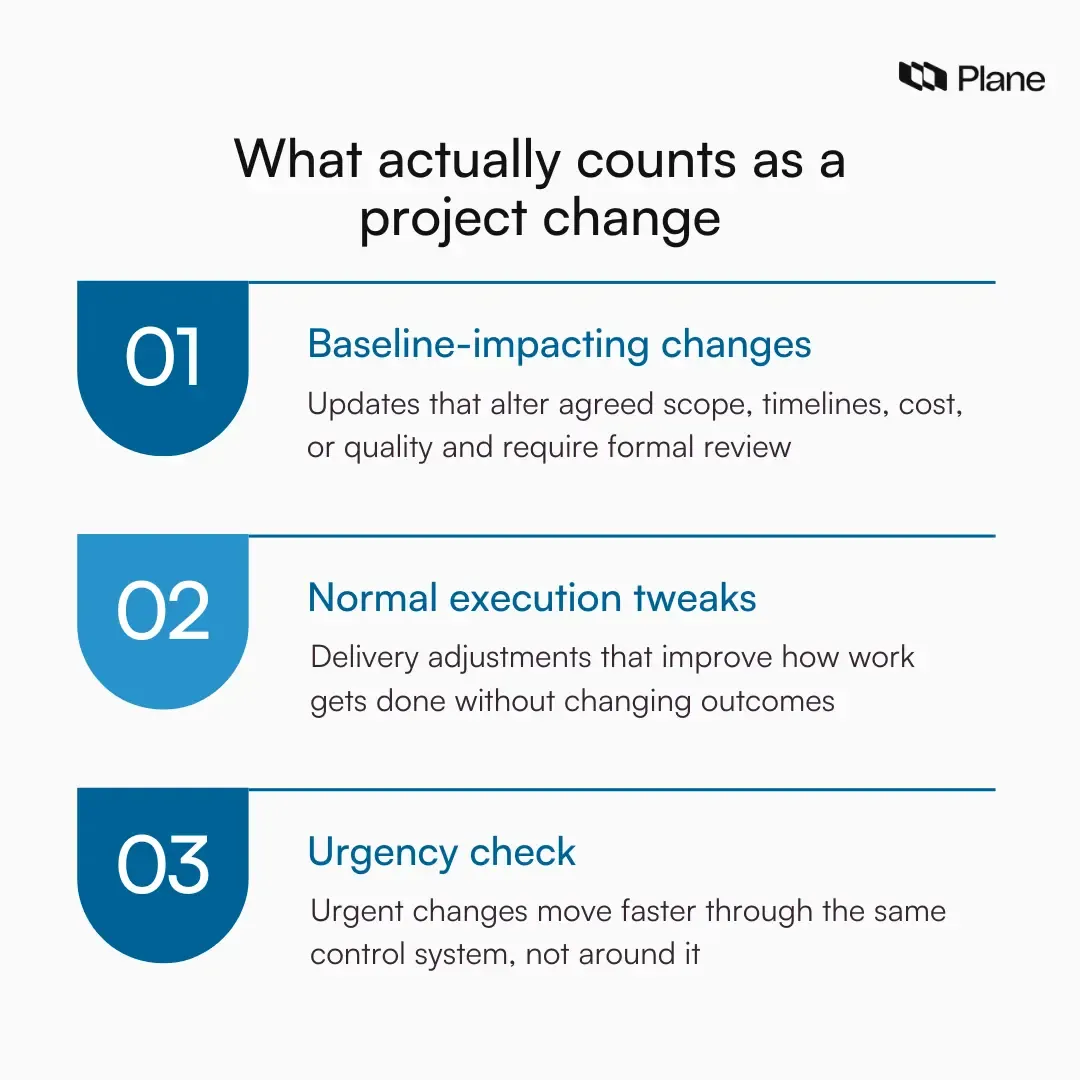

Graphic showing how to determine whether a project update requires change control or can be handled as normal execution.

Baseline-impacting changes

A change belongs in project change control when it alters the approved project baseline. The baseline is what stakeholders agreed to in terms of scope, schedule, cost, and quality. These changes always require a change request and review because they modify that agreement.

Common baseline-impacting changes include:

  • Adding or removing features or deliverables
  • Shifting deadlines or milestones
  • Increasing or reducing the budget
  • Changing staffing levels or key roles
  • Introducing new compliance, security, or quality requirements

A simple rule helps. If the update changes what stakeholders expect to receive, when they expect it, or how much it will cost, it is a change.

Normal execution tweaks

Some updates happen as part of healthy project execution. These do not change the baseline and do not need formal change control.

They usually involve:

  • Refining how work is implemented
  • Breaking down tasks in more detail
  • Adjusting technical approaches
  • Reordering work within the same deadline
  • Updating estimates as more information becomes available

These decisions affect how the team works, not what the project delivers. They belong in the team’s delivery workflow rather than the change control system. A practical test is whether the promised outcome to stakeholders remains the same.

Urgent vs. non-urgent changes

Not all changes move at the same speed. Modern change control separates urgency from importance, so teams respond quickly without losing control.

  • Urgent changes are required when a delay creates an immediate risk. Examples include security issues, legal obligations, production incidents, or critical customer commitments. These go through a fast review path with a clear decision owner and immediate baseline updates.
  • Non-urgent changes include most scope additions, enhancements, and improvement requests. These follow the standard change-control process, allowing teams to assess trade-offs, capacity, and priority.

Why this distinction matters

This structure prevents two common failures. Teams avoid slowing delivery with unnecessary approvals, and they avoid hidden scope growth that damages timelines and budgets later. Strong change control in project management depends on this clarity.

If you are learning how scope changes quietly disrupt delivery, our guide on how to manage project constraints explains how scope, time, and cost stay connected in real projects.

Change control vs. change management

Change control and change management are often used as if they mean the same thing, but they serve very different roles in modern project delivery.

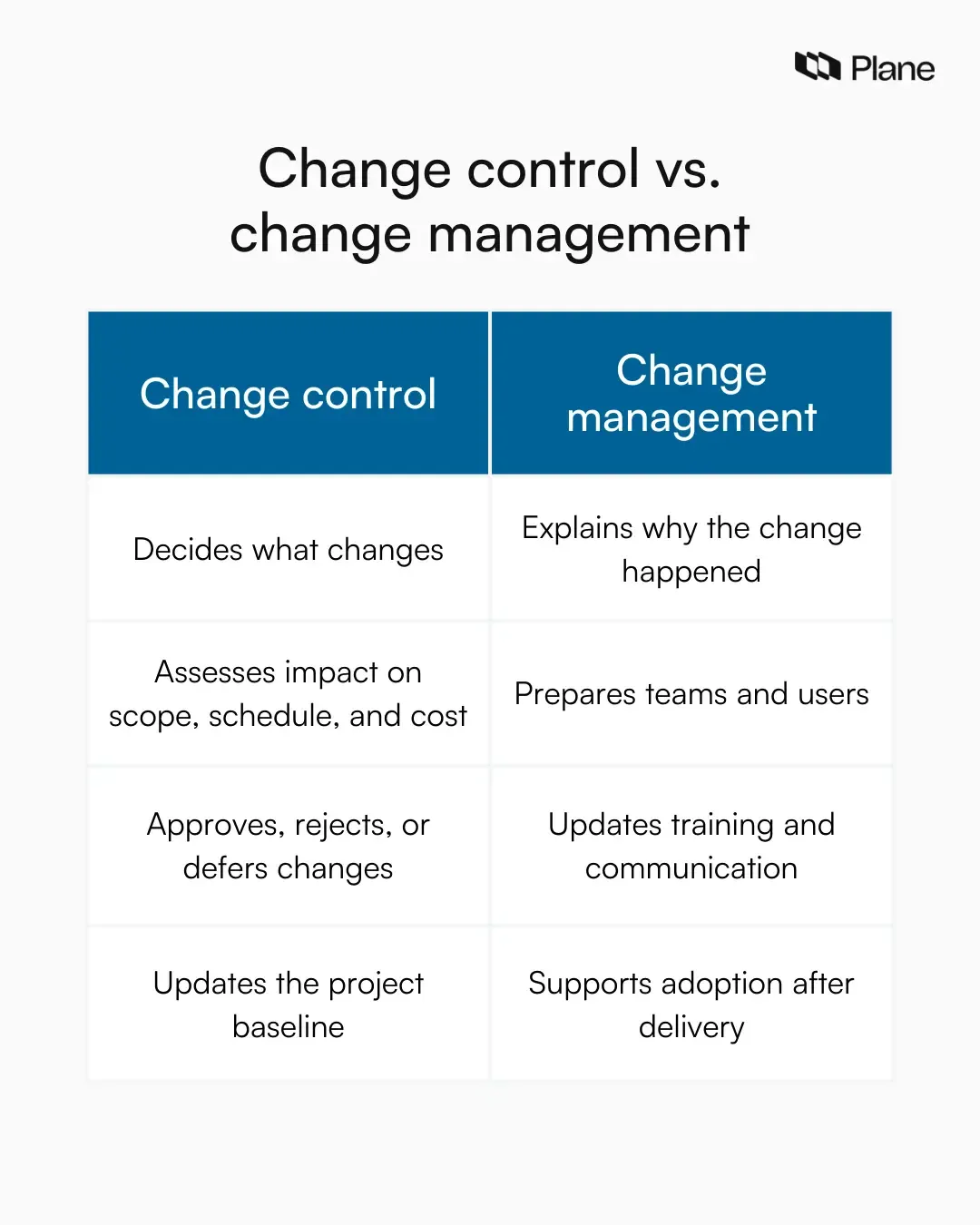

Side-by-side comparison showing change control as a decision and documentation system and change management as a people and adoption system in project management.

What change control does

Change control in project management is a decision-and-documentation system. It answers structured questions every time a change appears. What is being changed? Why is it needed? How it affects scope, schedule, cost, and quality. Who approved it? When it takes effect. The change control process creates a clear record of decisions and updates the project baseline, so everyone works from the same version of the plan. This gives teams a reliable source of truth for what the project now includes.

What change management does

Change management focuses on people, communication, and adoption. It examines how teams, customers, and stakeholders experience change. This includes preparing users, explaining why the change happened, updating training, and making sure the organization can actually use what was delivered. Change management does not decide whether a change should happen. It makes sure people understand and accept the change once it is approved.

How they work together

In a modern change control system, these two disciplines support each other. Change control decides what gets built and records the impact on the project. Change management ensures that the approved change succeeds in the real world. When they stay connected, teams avoid building the wrong thing or shipping the right thing without anyone ready to use it.

When formal change control is required

Not every project needs a heavy process, but some situations make formal change control essential. In these cases, even small changes can have serious consequences, so teams need a clear way to review, approve, and document every update.

1. External clients or contracts

When work is tied to a client contract, changes affect legal and commercial commitments. A new requirement, a deadline shift, or a scope reduction changes what both sides agreed to. Formal change control creates a clear record of what was requested, what was approved, and how it changes delivery and billing. This protects both the team and the client from disputes later.

2. Regulatory or compliance work

Projects in areas such as finance, healthcare, or security have strict rules about what must be delivered and how it is documented. A small change can create compliance risk. A structured change control process ensures that every adjustment is reviewed, approved, and traceable, keeping the project aligned with regulations and audit requirements.

3. Multiple stakeholders

When many teams or leaders have a stake in the outcome, informal decisions break down. One group may approve a change without realizing its impact on another. Project change control provides a shared system where every stakeholder sees the same request, the same impact analysis, and the same final decision.

4. Tight budgets or deadlines

Projects with little margin for error need strong control over changes. A small scope increase can cause missed deadlines or cost overruns. Formal change control makes these trade-offs visible before teams commit, so leaders can decide what to add, delay, or remove.

5. Large cross-team dependencies

When work spans multiple teams, one change often creates work for several groups. Without a change control system, these dependencies get missed. Integrated change control ensures that schedule, resources, and delivery plans across teams stay aligned as changes move forward.

Roles involved in change control

Modern change control only works when responsibility is distributed across the people who request, evaluate, decide, and deliver change. Each role protects a different part of the project.

1. Requester

The requester is the person who identifies a gap, risk, or opportunity and asks for a change. This could be a customer, a stakeholder, or someone on the delivery team. Their responsibility is not to propose a solution, but to clearly explain what problem exists, what outcome is needed, and why it matters. A strong change request gives enough context for others to judge its impact on the project.

2. Project manager

The project manager runs the change control system. They make sure every change request enters a single workflow instead of living in emails or chat threads. They coordinate impact analysis, bring the right people into the discussion, and ensure that decisions are recorded and reflected in the project baseline. In project change control, the project manager keeps the process reliable and visible.

3. Change control board or approvers

The change control board or the assigned approvers hold decision authority. Their role is to weigh the value of the change against its impact on scope, schedule, cost, and risk. They decide whether the project should absorb the change, defer it, or reject it. This protects the project from drifting away from business goals.

4. Sponsors and stakeholders

Sponsors and key stakeholders represent the business and customer perspective. They focus on outcomes, priorities, and return on investment. Their input ensures that change decisions support what the project exists to achieve rather than just what feels urgent.

5. Delivery owners

Delivery owners, such as engineering leads or functional managers, are responsible for execution. They explain what it will take to implement the change, how much effort it requires, and how it affects existing commitments. Their input turns abstract requests into real delivery impact.

How responsibility stays balanced

Change control in project management works because no single role decides on its own. Requesters bring the need, delivery owners explain the cost, sponsors define the value, and approvers make the call while the project manager keeps everything connected. This balance keeps change decisions grounded in both business goals and delivery reality.

The change control process

A solid change control process keeps projects adaptable while protecting delivery commitments. The steps below work across software, product, and cross-functional projects because they focus on one thing: making every change visible, evaluated, and traceable.

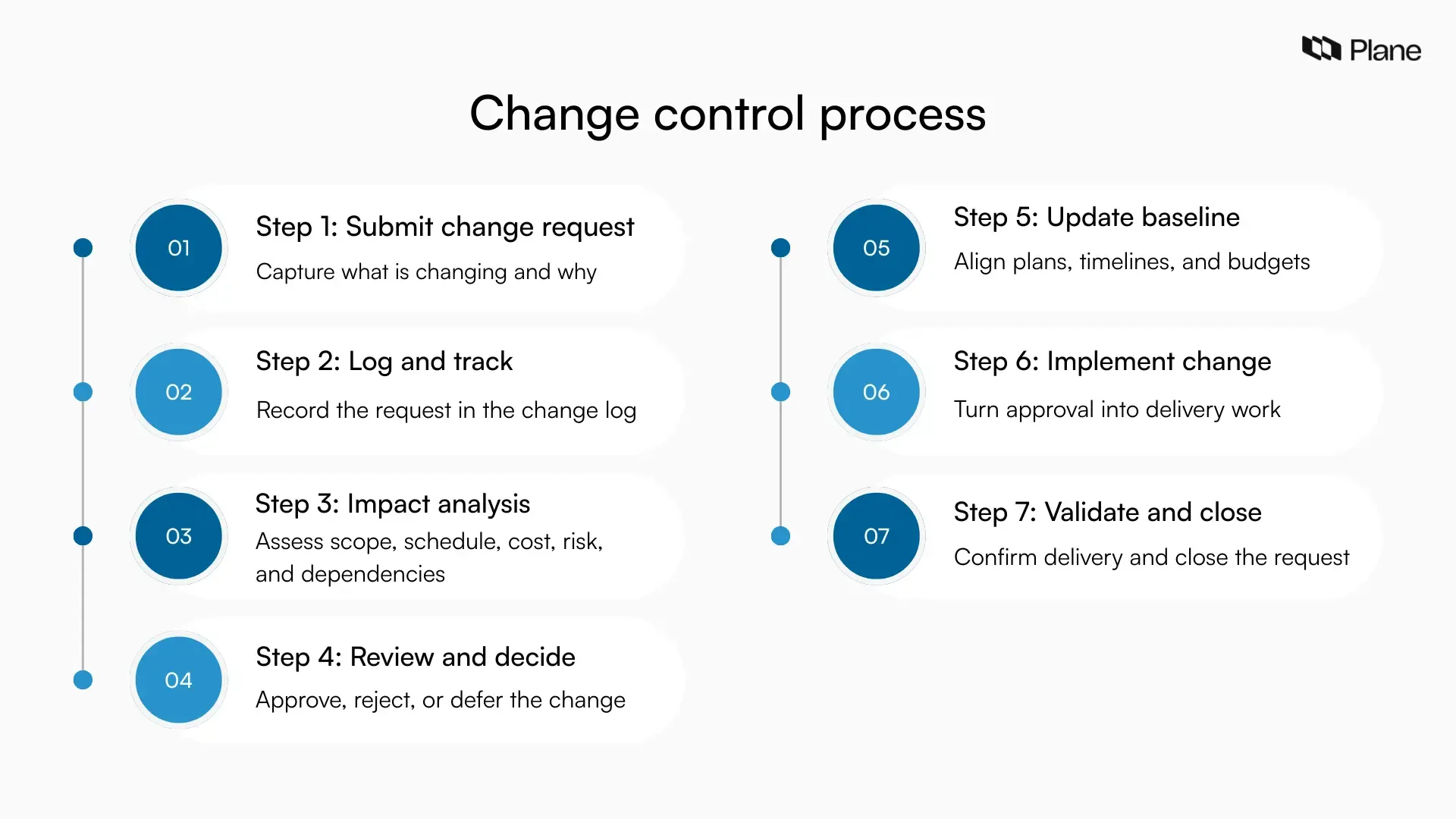

Graphic showing the step-by-step change control process from submitting a change request through impact analysis, approval, implementation, and closure.

1. Submit the change request

A change request is the starting point for project change control. It turns an informal request into something the team can review properly.

What to include and why:

  • What is changing, so everyone evaluates the same request
  • Why the change is needed, so the value is clear, not assumed
  • Desired outcome, so the team can validate success later
  • Who is requesting it, so ownership and context are clear
  • Priority and timing, so urgency is explicit
  • Initial impact guess, so reviewers know what to investigate

Example: a stakeholder asks to add “export to csv” to a reporting feature. The change request should state the user problem, the expected outcome, and the desired timing, rather than a vague message like “please add export.”

2. Log and track the request

Once submitted, the request is added to the change log or change register. This becomes the system of record for change control in project management.

What the change log tracks:

  • Request id and title
  • Requester and date submitted
  • Status, such as under review, approved, deferred, rejected
  • Decision owner and decision date
  • Summary of impact and final outcome

Why it matters: Change control fails when requests live in scattered threads. A change log keeps the history clear, supports audits, and prevents repeat discussions.

3. Perform impact analysis

Impact analysis is the core of the change control process. It answers one question: what does this change cost the project, and what trade-offs does it create?

  • Scope impact: Scope impact explains what will be added, removed, or modified. It clarifies whether the change expands the deliverable or reshapes existing work. Example: “add export to csv” expands the feature scope. “change button label text” stays within the same scope.
  • Schedule impact: Schedule impact explains how timelines shift. This includes delivery dates, milestones, and sequencing. Example: adding export may push the release by one week, or it may require moving another feature to the next cycle.
  • Cost impact: Cost impact includes budget changes, vendor spend, and operational costs. Example: exporting requires a third-party library license or additional cloud costs to generate large files.
  • Resource impact: Resource impact covers team capacity and skills. It highlights whether the change needs additional people, different expertise, or extra coordination. Example: export requires backend work, frontend updates, and qa testing. If the backend engineer is already committed, the change affects either delivery timing or priorities.
  • Risk impact: Risk impact looks at what can go wrong. It includes technical risk, quality risk, security risk, and stakeholder risk. Example: exporting data introduces a data leakage risk if permissions are not handled correctly. It also introduces performance risk if export jobs overload the system.
  • Dependency impact: Dependencies are the hidden cost in modern delivery. A change might require work from other teams or rely on systems that are not ready. Example: export depends on a data model update and analytics pipeline changes owned by another team. That dependency increases schedule risk and coordination effort.

A strong impact analysis ends with a clear trade-off statement. If the change is approved, what gets delayed, removed, or deprioritized?

4. Review and make a decision

After impact analysis, the request goes to the decision maker, which could be a change control board or a single approver, depending on the project.

Decision outcomes:

  • Approve whenthe value justifies the impact, and capacity exists
  • Reject when the change does not support goals, creates high risk, or lacks clarity
  • Defer when the change has value, but timing is wrong

Example decision: approve the export to csv, defer it to the next release, and remove a lower-priority enhancement from the current cycle to protect the deadline. The decision should be recorded with a short explanation so future discussions are easier.

5. Update the project baseline

Approval only matters when the baseline reflects the new reality. This step prevents drift between plans and execution.

What gets updated:

  • Scope baseline, such as requirements, acceptance criteria, and deliverables
  • Schedule baseline such as milestones, release dates, timelines
  • Cost baseline, such as budget allocations, expected spend
  • Resource plan, such as ownership, staffing, workload commitments
  • Risk register if the change creates or increases risk

Example: if export is approved for the next release, the roadmap and cycle plan should reflect that, along with the updated effort and risk notes.

6. Implement the change

Implementation is where approved changes become real delivery work. This step connects change control to execution.

What implementation includes:

  • breaking the change into work items
  • assigning owners and deadlines
  • scheduling it into the right cycle or sprint
  • tracking progress and blockers
  • communicating status to stakeholders

Example: export becomes a set of work items such as api endpoint, permissions, ui export flow, background job handling, qa test cases, and documentation updates.

7. Validate and close

Closing a change request means confirming that the approved change was delivered as agreed and that the record is complete.

What to capture:

  • What was delivered and when
  • Validation method, such as testing, stakeholder sign-off, production verification
  • Final notes on impact, including unexpected delays or new risks
  • Links to related work items and documentation

Example: export ships in release 1.8, QA confirms the permission rules, and the requester signs off after testing in production. The change log is updated to close with a short summary.

When teams run this end-to-end, change control in project management becomes a practical system that supports speed and clarity, rather than a bureaucratic layer.

Integrated change control

Integrated change control is what keeps a project aligned after a change is approved. It ensures that decisions do not stay locked inside a meeting or a document, but flow into every part of the project that guides execution.

When a change is approved, several things must be updated together. The scope documents need to reflect what will now be delivered. The schedule must show new timelines or sequencing. The budget and resource plans need to match the new level of effort. Risk and dependency tracking should reflect what the change introduced. If even one of these stays outdated, teams start working from different versions of the truth.

In modern project change control, integration is what turns approval into reality. The change request links to updated plans, work items, and milestones so everyone sees the same project state. Teams no longer ask which document is correct because the system of record shows the current baseline. This keeps delivery, reporting, and stakeholder expectations in sync as the project evolves.

If you are struggling to keep plans, documentation, and execution in sync, our guide on project summary in project management explains how teams maintain a single source of truth as projects evolve.

Key change control documents

Change control in project management works because every decision leaves a clear trail. These documents give teams visibility into what changed, why it changed, and what the project now looks like.

1. Change request form

The change request form captures the request in a structured way. It records what is being asked for, why it matters, and who raised it. This prevents important details from getting lost in conversations and gives reviewers a consistent way to evaluate every request.

2. Change log or change register

The change log is the central system of record for project change control. It tracks every change request from submission to closure. Teams use it to see what is under review, what was approved, what was rejected, and how each decision affected the project. Over time, it also becomes a history of the project's evolution.

3. Impact assessment

The impact assessment explains what a change will do to scope, schedule, cost, resources, risk, and dependencies. It turns an idea into a concrete trade-off. Without this document, decisions rely on assumptions rather than data.

4. Decision record

The decision record captures the final outcome. It states whether the change was approved, rejected, or deferred and includes a short reason. This keeps everyone aligned and avoids reopening the same debate later.

5. Updated baselines

Once a change is approved, the project baselines are updated to reflect the new reality. This includes scope documents, timelines, budgets, and resource plans. These updated baselines ensure that everyone works from the same version of the plan as the project moves forward.

Types of project changes teams deal with

Project change control becomes easier when teams recognize the common categories changes fall into. Each type affects the project baseline in a different way and requires careful review.

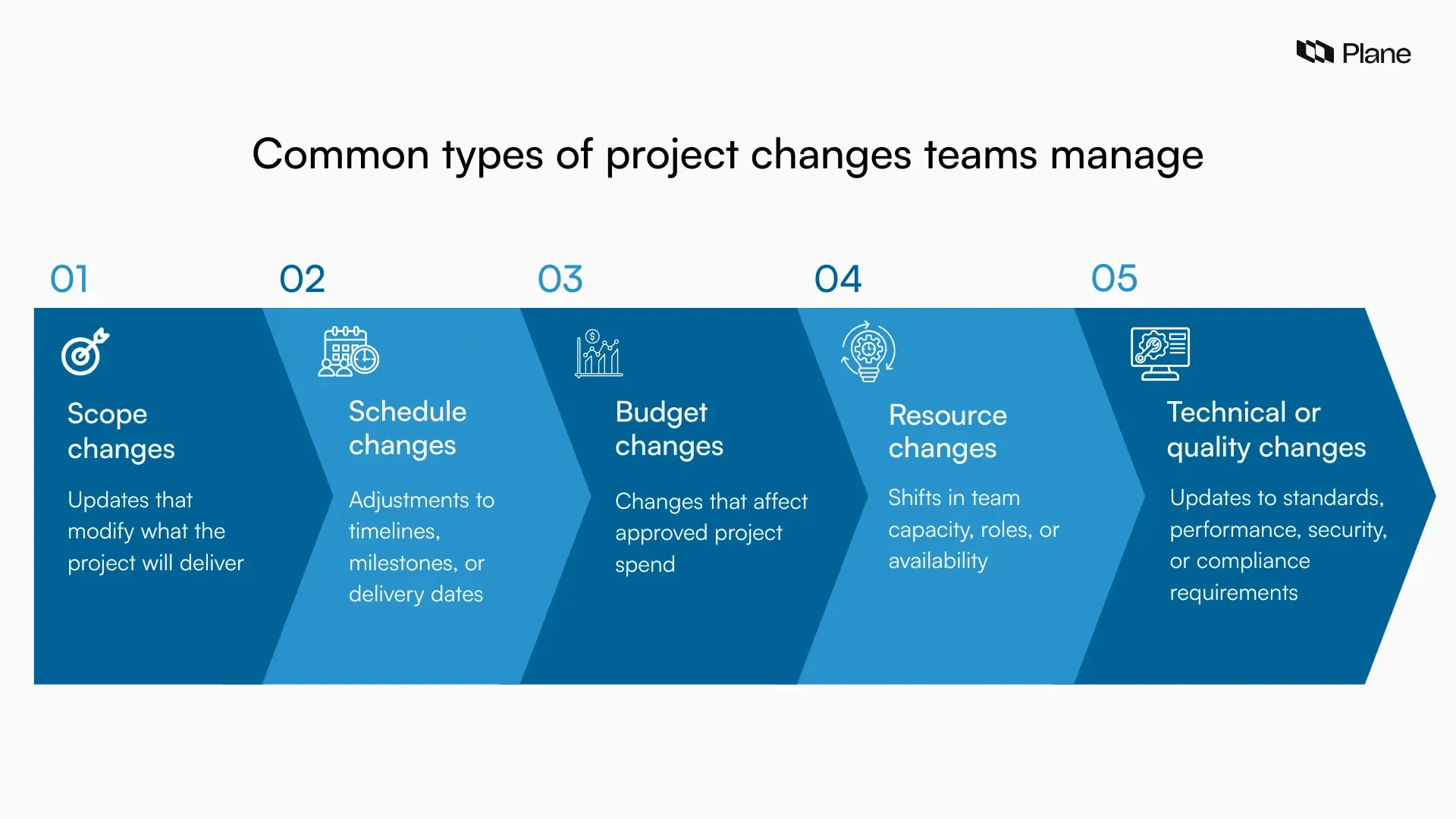

Graphic showing common types of project changes, including scope, schedule, budget, resource, and technical or quality changes, connected to the project baseline.

1. Scope changes

Scope changes alter what the project will deliver. This includes adding new features, removing requirements, or changing acceptance criteria. Even small scope changes increase effort and coordination, which is why they often lead to schedule and cost impact if not reviewed properly.

Example: Midway through a release, a stakeholder requests an additional reporting filter that was not part of the original requirements. Adding it expands the scope and requires unplanned design, development, and testing work.

2. Schedule changes

Schedule changes affect when work is delivered. These include deadline shifts, milestone updates, or changes in sequencing. A schedule change often forces teams to reprioritize work or adjust capacity, which makes formal change control essential.

Example: A launch date is moved forward by two weeks due to a marketing commitment. To meet the new deadline, the team must drop lower-priority features or add temporary capacity.

3. Budget changes

Budget changes modify how much the project can spend. Additional funding may enable more work, while budget reductions usually require adjustments to scope or timeline. Project change control ensures these trade-offs are explicit before decisions are made.

Example: Leadership approves extra budget to support a new integration. The additional funding allows the team to bring in a contractor and expand the project scope without delaying delivery.

4. Resource changes

Resource changes involve people and capacity. This includes adding or removing team members, changing roles, or reallocating people across projects. Because capacity drives delivery, these changes directly affect timelines and risk.

Example: A senior engineer is reassigned to another project for a month. The remaining team needs more time to complete planned work, which impacts the schedule and risk profile.

5. Technical or quality changes

Technical and quality changes update how the solution is built or the standards it must meet. Examples include new security requirements, performance targets, or compliance rules. These changes often increase complexity and effort, which is why they belong in the formal change control process.

Example: A new data protection requirement requires encryption at rest. This introduces additional development work, testing, and validation that were not part of the original plan.

Final thoughts

Change is unavoidable in modern projects, but unmanaged change is what causes delays, budget overruns, and lost trust. Change control in project management gives teams a clear way to adapt without losing control of delivery. When change requests are evaluated, documented, and integrated into the project baseline, teams stay aligned on what is being built and why. A strong change control process does not slow teams down. It creates clarity, shared ownership, and confidence as projects evolve.

Frequently asked questions

Q1. What are the five stages of change control?

The five stages of change control in project management are submitting the change request, logging and tracking the request, performing impact analysis, reviewing and deciding on the change, and updating the project baseline after approval. These stages ensure every change is evaluated and recorded before it affects delivery.

Q2. What is a CRF in project management?

A CRF, or Change Request Form, is the document used to formally submit a change. It captures what is being requested, why the change is needed, who raised it, and the expected impact. The CRF is the starting point of the change control process.

Q3. What are the five project controls?

The five project controls typically refer to scope control, schedule control, cost control, quality control, and risk control. Together, they help teams track performance and manage changes across the key areas that define project success.

Q4. What are the 5 C’s of change?

The 5 C’s of change are commonly described as clarity, communication, coordination, commitment, and control. These principles help teams manage change in a structured and predictable way.

Q5. What are the 7 C’s of change?

The 7 C’s of change expand on the same idea and usually include clarity, communication, context, consistency, commitment, capability, and control. They provide a broader framework for managing change effectively across teams and stakeholders.

Recommended for you

View all blogs
Plane

Every team, every use case, the right momentum

Hundreds of Jira, Linear, Asana, and ClickUp customers have rediscovered the joy of work. We’d love to help you do that, too.
Plane
Nacelle
