Capacity planning: Strategies, types, and best practices

Sneha Kanojia
27 Feb, 2026
Illustration titled “How teams forecast and manage capacity” showing a balance scale with demand and available capacity represented on each side.

Introduction

Every team has a capacity ceiling. Cross it, and deadlines slip, burnout rises, and delivery quality drops. Stay well below it, and you're leaving business value on the table. Capacity planning is how high-performing engineering and product teams find that line and operate confidently around it. This guide breaks down the core strategies, types, and best practices of resource capacity planning so your team can forecast more accurately, allocate resources more effectively, and ship consistently.

What is capacity planning?

Capacity planning is the process of determining whether your team has the people, skills, time, and resources required to meet current and future project demands. In project management, it sits at the intersection of forecasting and execution, translating business goals into realistic delivery plans before work begins, rather than after things break down.

What "capacity" actually means

Most teams reduce capacity to headcount. That's a costly oversimplification. True capacity is multi-dimensional:

Graphic showing team capacity at the center surrounded by four dimensions: time availability, skills and expertise, tools and infrastructure, and financial and operational limits.

  • Available work hours: Not every working hour is a productive project hour. Meetings, reviews, on-call rotations, and context-switching all eat into the time your team can realistically commit to planned work.
  • Skills and expertise: A team of ten means nothing if the two engineers with the required expertise are already at 100% utilization. Capacity planning accounts for skill-specific availability, not just aggregate headcount.
  • Tools and infrastructure: Compute limits, licensing constraints, and tooling bottlenecks can limit what a team delivers, regardless of available headcount.
  • Budget and operational limits: Resource capacity planning always operates within financial boundaries. Headcount can be available on paper, but unavailable in practice if the budget ceiling has been reached.

The goal of capacity planning

The goal is precise: match incoming demand with realistic supply. That means committing to work your team can actually finish, distributing load evenly across people and skill sets, and building in enough breathing room to handle the unplanned work that always surfaces. Done well, capacity planning in project management keeps teams productive without pushing them into chronic overload or leaving expensive resources sitting idle.

Why capacity planning matters

Team capacity planning is where strategy meets execution. Without it, delivery becomes reactive, priorities shift arbitrarily, and the people doing the work absorb the cost of poor planning. Here's what changes when you get it right.

Grid graphic showing four benefits of capacity planning: predictable delivery, stronger prioritization, balanced workload, and better resource utilization.

1. More predictable delivery

Predictable delivery begins with realistic commitments. When team capacity is calculated before roadmap items are locked, deadlines reflect actual availability rather than ambition. Capacity planning strategies help teams forecast workload across sprints, quarters, and releases, reducing last-minute scope shifts and urgent reprioritization.

2. Better prioritization

Every initiative consumes resource capacity. When leaders see how much work fits within existing bandwidth, prioritization becomes evidence-based. Capacity planning surfaces trade-offs early, forcing clear decisions about what moves forward, what shifts timelines, and what requires additional workforce capacity planning.

3. Healthier workload distribution

Uneven workload distribution often hides behind aggregate numbers. One engineer handles high-complexity tasks while others operate at suboptimal utilization. Capacity planning best practices require visibility at the individual and role level, enabling balanced workload across projects and reducing sustained overload.

4. Improved resource utilization

Effective capacity planning ensures specialized skills are allocated intentionally. High-value expertise aligns with strategic initiatives, operational work receives dedicated bandwidth, and project capacity planning reflects actual constraints. This alignment strengthens output quality while preserving long-term team performance.

Capacity planning gets conflated with resource planning and capacity management often enough that teams end up doing none of them well. Here's how they actually differ.

Capacity planning vs. resource planning

These two operate in sequence, not in parallel.

  • Capacity planning answers the question: "Do we have enough to take this on?" It looks at aggregate availability, skill coverage, and workload thresholds before any commitment is made.
  • Resource planning comes after: "Who specifically will do this work, and when?" One sets the boundaries, the other fills them. Treating them as the same process is why teams over-commit and under-deliver.

Capacity planning vs. capacity management

  • Capacity planning is a forward-looking exercise. It happens before a project kicks off, before a sprint begins, before a hiring decision is made.
  • Capacity management is what happens after, continuously monitoring actual utilization against the plan, catching drift early, and making real-time adjustments when demand shifts or resources change.

Planning without management is a forecast that never gets validated. Management without planning is firefighting with better data.

Comparison table

Concept
Primary question
When it happens
Key output

Capacity Planning

How much can we take on?

Before work begins

Realistic commitments and forecasts

Resource Planning

Who will do the work?

After capacity is confirmed

Assignments and schedules

Capacity Management

Are we on track?

Continuously during execution

Adjustments and reallocation decisions

Types of capacity planning

Capacity planning applies across industries and operational models. While the underlying principle remains consistent, the scope and constraints vary depending on context. Understanding the different types of capacity planning helps teams choose the right planning lens for their environment.

Graphic listing five types of capacity planning: workforce, project or team, production, infrastructure or IT, and Agile capacity planning.

1. Workforce capacity planning

Workforce capacity planning focuses on people. It evaluates available work hours, role distribution, and skill coverage across the organization. Leaders assess hiring needs, identify skill gaps, and ensure that upcoming initiatives align with existing expertise. In software teams, workforce capacity planning often determines whether roadmap goals require additional hiring, cross-training, or external support.

2. Project or team capacity planning

Project capacity planning evaluates whether a specific team can deliver its planned initiatives within a defined time frame. It aligns team capacity with project scope, milestones, and deadlines. This type of capacity planning in project management is common in product and engineering environments where multiple initiatives compete for the same resource capacity.

3. Production capacity planning

Production capacity planning applies to manufacturing and operations environments. It evaluates output volume, equipment throughput, material availability, and process efficiency. The focus lies on ensuring production systems can meet demand targets while maintaining cost efficiency and operational stability.

4. Infrastructure or IT capacity planning

Infrastructure capacity planning addresses technical systems such as servers, cloud environments, storage, and network capacity. It forecasts usage growth, traffic spikes, and system constraints to maintain performance and reliability. For software organizations, infrastructure capacity planning ensures that product growth aligns with technical scalability.

5. Agile capacity planning

Agile capacity planning operates within time-boxed delivery cycles such as sprints or iterations. Teams estimate upcoming work, calculate team capacity for the sprint, and commit based on realistic throughput. Agile capacity planning supports sustainable velocity, balanced workload across projects, and improved forecasting accuracy over multiple cycles.

Capacity planning strategies

Every team makes a strategic choice about when to add capacity relative to demand. Most make it implicitly, by defaulting to whatever feels safest in the moment. The three classic capacity planning strategies make that choice explicit so you can defend it with data.

Comparison graphic showing three capacity planning strategies: lead, lag, and match, with approach, best use case, and primary risk for each.

1. Lead strategy

The lead strategy increases capacity before demand fully materializes. Organizations hire, train, or invest in infrastructure in anticipation of growth.

This strategy works well when demand forecasts are reliable, and the market opportunity requires a rapid response. Product companies launching major features, expanding into new markets, or preparing for seasonal traffic spikes often apply this approach.

How to apply this;

  • Forecast demand using historical growth and roadmap commitments.
  • Model required workforce capacity planning scenarios six to twelve months ahead.
  • Secure hiring approvals early and align onboarding with expected demand windows.
  • Ensure infrastructure capacity planning supports projected increases in load.

Lead strategy strengthens responsiveness and market positioning while increasing financial exposure if demand forecasts overestimate.

2. Lag strategy

The lag strategy expands capacity only after demand becomes measurable and sustained. Hiring or infrastructure investment follows confirmed growth in workload. This approach reduces financial risk and supports controlled scaling. It suits organizations operating in uncertain markets or with constrained budgets.

Action steps:

  • Track workload trends and resource capacity utilization monthly.
  • Define clear thresholds that trigger hiring or scaling decisions.
  • Prioritize high-impact initiatives within the team's existing capacity.
  • Use short-term contract support during temporary spikes.

Lag strategy protects cash flow and cost efficiency, while increasing delivery pressure when demand accelerates rapidly.

3. Match strategy

The match strategy adjusts capacity incrementally in response to validated demand signals. Instead of committing fully ahead or waiting entirely, leaders expand gradually as patterns stabilize.

This balanced approach fits many modern software organizations where demand evolves steadily rather than abruptly.

Action steps:

  • Review team capacity and workload distribution at regular intervals.
  • Scale hiring in phases aligned to milestone achievements.
  • Cross-train team members to increase flexible resource capacity.
  • Use rolling forecasts to refine projections quarterly.

Match strategy balances risk and responsiveness, supporting sustainable growth.

How to choose the right strategy

Selecting a capacity planning strategy requires a structured evaluation of operational variables. Leaders should assess:

  • Demand predictability: Stable demand supports the lead strategy. Volatile demand favors lag or match.
  • Cost of overcapacity: High fixed salary costs or infrastructure expenses increase financial risk when excess capacity remains unused.
  • Cost of delay: Missed market windows, lost revenue, or competitive disadvantage increase the cost of insufficient capacity.
  • Hiring and scaling speed: Long recruitment cycles or specialized skill requirements may require earlier capacity expansion.

Quick decision guide

Scenario
Recommended Strategy
Rationale

Predictable growth with strong revenue visibility

Lead strategy

Early investment supports rapid scaling and market capture

Uncertain demand with tight budget constraints

Lag strategy

Controlled expansion reduces financial exposure

Steady growth with moderate variability

Match strategy

Incremental scaling balances risk and responsiveness

High cost of delivery delay

Lead or match

Protects timelines and strategic milestones

High cost of unused capacity

Lag

Preserves cost efficiency

Capacity planning strategies work best when revisited quarterly and aligned with strategic capacity planning goals. The chosen approach should integrate with workforce, project, and infrastructure capacity planning to ensure organization-wide alignment.

Capacity planning across time horizons

Capacity planning is an ongoing process, not just a single meeting or one-time task. It spans three distinct time horizons, each addressing a specific planning layer and answering a unique set of questions. Let’s explore them:

Graphic showing strategic, tactical, and operational capacity planning connected from long-term growth goals to quarterly roadmaps to sprint-level execution.

1. Strategic capacity planning

Strategic capacity planning focuses on long-term growth, typically spanning one to three years. Leaders forecast market expansion, product portfolio growth, and expected demand, then evaluate whether current workforce capacity planning and infrastructure capacity planning can support that trajectory.

At this level, decisions include hiring plans, skill development programs, geographic expansion, and investments in platform scalability. Strategic capacity planning ensures that business ambitions remain grounded in measurable resource capacity and realistic scaling timelines.

2. Tactical capacity planning

Tactical capacity planning connects strategy to execution over quarterly or monthly cycles. Product roadmaps, major releases, and cross-team initiatives are evaluated against available team capacity during this period.

Here, project capacity planning becomes critical. Leaders translate roadmap initiatives into estimated effort, assess workload across projects, and determine whether existing teams can deliver within the quarter. Adjustments may include shifting timelines, resequencing initiatives, or reallocating resources across teams.

Tactical planning provides structured checkpoints that keep long-term goals aligned with current execution capacity.

3. Operational capacity planning

Operational capacity planning governs weekly execution, sprint planning, and short-term adjustments. Agile capacity planning typically operates at this level, where teams calculate available hours for a sprint, commit to work based on historical throughput, and monitor progress closely.

This layer reflects real-time conditions, including unplanned support work, dependencies, and workload distribution across individuals. Operational capacity planning ensures that commitments reflect the team's actual capacity for the current cycle, strengthening predictability and sustainable delivery.

The capacity planning process: Step by step

Capacity planning works best as a repeatable operating rhythm. The goal stays consistent: forecast demand, calculate team capacity, translate work into effort, and commit based on measurable resource capacity.

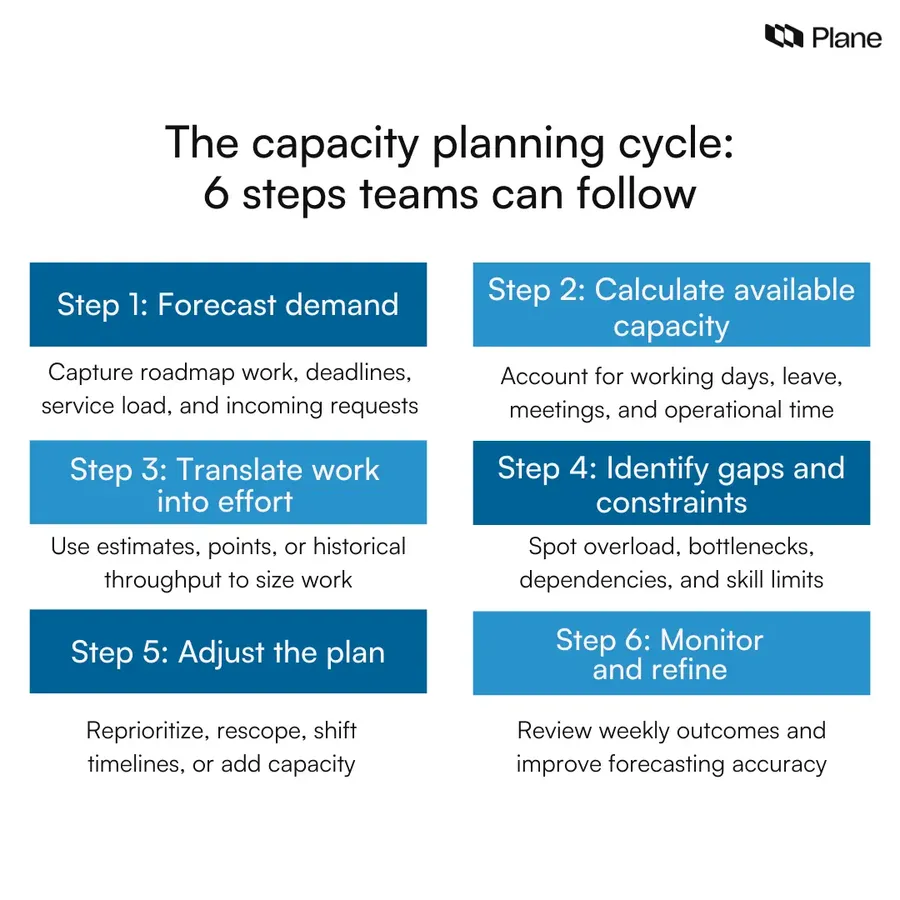

graphic showing six steps in the capacity planning process: forecast demand, calculate capacity, estimate effort, identify constraints, adjust plans, and refine weekly.

This step-by-step process fits product teams planning quarterly roadmaps, engineering teams planning sprints, and leaders balancing workload across projects.

Step 1: Forecast demand

Start by creating a clear inventory of incoming work. For most teams, demand comes from multiple streams: roadmap initiatives, stakeholder requests, launch deadlines, service work, and operational responsibilities such as on-call support. Capture each item at a consistent granularity so demand stays comparable. When you mix large epics with small fixes, forecasting becomes noisy and prioritization drifts.

For capacity planning in project management, demand forecasting improves when each request includes a clear outcome, a target window, and a confidence level. This helps teams separate committed work from exploratory work and reduces mid-cycle scope creep.

Step 2: Calculate available capacity

Team capacity starts with calendar time, then moves quickly into reality. Calculate available work hours for the planning window, then subtract planned leave, public holidays, recurring meetings, and non-project commitments. Most teams also carry operational load such as code reviews, incident response, customer escalations, and internal enablement. Treat these as first-class capacity consumers.

A practical approach is to define an expected allocation split for each role, such as delivery work, operational work, and collaboration time. This makes workload distribution visible and strengthens workforce capacity planning.

Step 3: Translate work into effort

Once demand is visible and team capacity is grounded, translate work into an effort signal. Teams use different units based on maturity and workflow: estimated hours, story points, t-shirt sizing, or historical throughput. What matters is consistency.

If your team already tracks cycle throughput or sprint velocity, use that data as the baseline for agile capacity planning. If you plan across multiple projects, ensure effort estimates account for context switching and dependency overhead. This step bridges capacity planning strategies and day-to-day commitments.

Step 4: Identify gaps and constraints

Compare demand against available resource capacity. Gaps show up as overload within a sprint, an overfilled quarter, or a skill mismatch where one specialist becomes the bottleneck. Constraints often emerge from dependencies, approval queues, shared infrastructure, or limited testing environments.

This step should surface two kinds of problems early: volume constraints, where too much work is available for the time available, and capability constraints, where the right skills or tools are unavailable. Clear identification supports project capacity planning decisions and reduces late-stage delivery risk.

Step 5: Adjust the plan

Capacity planning becomes valuable when it produces trade-offs. Adjustments typically fall into a few categories: shifting priorities, splitting scope into smaller deliverables, moving timelines, redistributing work across teams, or increasing capacity through hiring, contractors, or automation.

For teams balancing workloads across projects, sequencing often offers the greatest leverage. When initiatives share people or dependencies, stagger their start dates to keep delivery focused. Strong capacity planning best practices also include setting a buffer for unplanned work, especially for teams with operational responsibilities.

Step 6: Monitor and refine

Capacity plans improve through feedback loops. Review actuals weekly: completed work, spillover, unplanned load, and estimate accuracy. Track where capacity assumptions diverged from reality, such as meetings expanding, support load increasing, or dependencies slowing execution.

Over time, these reviews build a reliable forecasting baseline. Teams improve how to calculate team capacity for a project by using real throughput data, refining effort sizing, and making operational load visible. This ongoing refinement connects capacity management to future planning cycles and strengthens predictability across releases.

How to calculate team capacity

Capacity planning becomes practical when teams can calculate project capacity using a simple, repeatable method. The objective is to translate calendar time into realistic delivery bandwidth. This approach works for quarterly roadmap planning, sprint planning, and multi-project workload balancing.

1. Start with gross capacity

Gross capacity represents the total theoretical work hours available within a planning window.

Formula: Working days × Hours per day × Team size

For example, consider a two-week sprint:

  • 10 working days
  • 8 hours per day
  • 5 engineers

Gross capacity = 10 × 8 × 5 = 400 hours

This number reflects theoretical availability before operational realities are taken into account.

2. Subtract non-project commitments

Next, account for recurring commitments that consume team capacity. These typically include:

  • Sprint ceremonies and recurring meetings
  • Code reviews and design reviews
  • Support and on-call responsibilities
  • Administrative and coordination work

Assume each engineer spends 2 hours per day on meetings and operational work:

  • 2 hours × 10 days × 5 engineers = 100 hours
  • Adjusted capacity = 400 − 100 = 300 hours

This adjusted number reflects the available delivery time before productivity factors.

3. Apply a focus factor

Even within the scheduled delivery time, productivity varies due to context switching, interruptions, and the overhead of collaboration. A focus factor accounts for realistic execution efficiency. Many software teams use a range between 70 percent and 85 percent based on historical throughput.

Using a 75 percent focus factor:

300 hours × 0.75 = 225 effective delivery hours

This number represents the realistic team capacity for planned work during the sprint.

4. Convert into planning units

Teams often plan using units other than hours. Once effective capacity is calculated, convert it into the unit used for agile capacity planning.

If historical data shows that the team delivers 1 story point per 3 hours, then:

225 effective hours ÷ 3 = 75 story points

This provides a grounded commitment threshold for sprint planning.

Example summary

  • Gross capacity: 400 hours
  • After non-project time: 300 hours
  • After focus factor: 225 effective hours
  • Equivalent commitment: 75 story points

This structured calculation strengthens project capacity planning and improves forecasting accuracy over time. When teams consistently compare planned effort against effective team capacity, workload across projects becomes measurable and predictable.

Common challenges in capacity planning

Capacity planning sounds structured in theory. In practice, friction appears at the intersection of real work, human behavior, and shifting priorities. Most failures in capacity planning in project management stem from recurring operational patterns rather than flawed formulas. Recognizing these patterns early strengthens capacity planning strategies and improves forecasting accuracy.

1. Hidden or unplanned work

Unplanned work consumes team capacity quietly. Production incidents, urgent customer requests, internal reviews, and cross-team dependencies often surface mid-cycle. When this operational load stays invisible during planning, commitments exceed realistic resource capacity.

High-performing teams treat service work and interruptions as forecastable demand. They allocate explicit bandwidth for support within workforce capacity planning instead of assuming full availability for roadmap work.

2. Skill bottlenecks

Capacity planning frequently focuses on aggregate hours while overlooking skill distribution. One engineer owns a critical system, one designer supports multiple initiatives, or one data specialist validates every release. This concentration creates a constraint that limits overall throughput.

Effective project capacity planning maps demand against specific expertise, not just headcount. When skill bottlenecks become visible, leaders can sequence work differently, invest in cross-training, or adjust hiring priorities.

3. Over-optimistic estimates

Estimation bias inflates team capacity assumptions. Large initiatives receive compressed effort estimates, dependencies remain underexplored, and integration complexity emerges late. As work unfolds, delivery windows shift and sprint spillover increases.

Capacity planning best practices require calibration using historical throughput. Teams improve forecasting by reviewing variance between planned and completed effort, refining estimation practices, and breaking initiatives into smaller, comparable units.

4. Stakeholder pressure

Stakeholders often evaluate capacity through ambition rather than measurable limits. New initiatives enter the roadmap without equivalent trade-offs, stretching team capacity beyond sustainable levels.

Strong capacity planning surfaces constraints transparently. When leaders quantify how much work fits into a quarter or sprint, trade-off discussions become data-driven. This clarity strengthens prioritization discipline and supports balanced workload across projects.

5. Static plans

Capacity plans lose relevance when they remain fixed while conditions evolve. Shifting priorities, team changes, hiring delays, and operational load fluctuations continuously alter available team capacity.

Capacity management complements capacity planning by introducing regular review cycles. Weekly or biweekly reviews of workload distribution, throughput, and utilization keep commitments aligned with current reality and reinforce long term predictability.

Capacity planning best practices

Capacity planning improves when it becomes a disciplined operating habit rather than a reactive correction. The following capacity planning best practices strengthen forecasting accuracy, protect team capacity, and align commitments with measurable resource capacity.

Grid graphic showing six capacity planning best practices: plan on a cadence, maintain a buffer, involve the team, make work visible, use scenario planning, and review performance data.

1. Plan on a consistent cadence

Capacity planning delivers value when it runs on a predictable rhythm. Strategic capacity planning may operate annually, tactical planning quarterly, and operational planning weekly or per sprint. A consistent cadence ensures that demand, workforce capacity planning, and project capacity planning stay aligned before pressure accumulates. Regular planning cycles also improve how teams calculate project capacity over time.

2. Keep a buffer

Every team operates within uncertainty. Production incidents, urgent stakeholder requests, and cross-team dependencies influence workload distribution. Effective capacity planning strategies include a defined buffer, often between 10 and 25 percent, depending on operational load. This reserved bandwidth stabilizes delivery timelines and strengthens agile capacity planning in sprint-based environments.

3. Involve the team

Accurate capacity planning depends on realistic input from those executing the work. Engineers and product managers understand context-switching costs, integration complexity, and dependency risk better than static spreadsheets do. When teams participate in estimating effort and validating available team capacity, commitments reflect operational reality rather than assumptions.

4. Make work visible

Hidden work distorts capacity planning in project management. Service requests, maintenance tasks, documentation, and cross-functional collaboration consume measurable resource capacity. Making all work visible within a shared system improves workload transparency and supports balanced allocation across projects. Visibility strengthens prioritization and reduces sudden overload.

5. Use scenario planning

Demand forecasts carry uncertainty. Scenario planning introduces structured flexibility by modeling different outcomes, such as conservative, expected, and accelerated growth cases. Leaders can evaluate how each scenario influences workforce capacity planning, hiring timelines, and infrastructure investment. This approach supports informed capacity planning strategies and strengthens decision-making under uncertainty.

6. Review performance data

Capacity planning matures through feedback loops. Teams should compare planned effort against completed work, measure throughput trends, and analyze workload distribution regularly. Historical data refines estimates, improves forecasting reliability, and strengthens capacity management practices. Over time, data-driven adjustments transform capacity planning from estimation into a measurable system of execution.

Capacity planning in Agile and product teams

For product and engineering organizations, capacity planning operates closest to execution. Agile delivery cycles, shared technical ownership, and evolving roadmaps create constant pressure on team capacity. Effective capacity planning in project management connects sprint commitments, cross-team coordination, and quarterly goals into a coherent system.

1. Capacity planning for sprint cycles

Sprint-level planning represents operational capacity planning in its most visible form. At the start of each sprint, teams calculate available work hours, account for leave and recurring commitments, and translate effective team capacity into story points or workload units.

Agile capacity planning strengthens predictability when historical throughput informs commitments. Instead of selecting work based solely on priority, teams align sprint scope with measured resource capacity. This improves delivery consistency, stabilizes velocity trends, and reduces mid-sprint scope shifts. Over multiple cycles, this feedback loop sharpens how teams calculate project capacity and refine estimation accuracy.

2. Capacity planning across multiple teams

As organizations scale, capacity planning expands beyond a single team. Shared resources such as platform engineers, designers, security reviewers, and data specialists often support multiple initiatives simultaneously. Without coordinated project capacity planning, these shared roles become invisible constraints.

Cross-team capacity planning requires a consolidated view of demand across roadmaps. Leaders evaluate aggregate resource capacity, identify overlapping commitments, and sequence work intentionally. Structured workforce capacity planning at this level supports balanced workload across projects and reduces cascading delivery delays caused by dependency bottlenecks.

3. Capacity planning for roadmap delivery

Quarterly roadmap planning operates at the tactical layer of capacity planning. Product leaders define goals, engineering estimates effort, and leadership aligns commitments with available team capacity.

Effective roadmap capacity planning translates strategic objectives into measurable delivery bandwidth. Teams evaluate whether existing resource capacity supports planned initiatives, whether sequencing adjustments improve feasibility, and whether additional hiring aligns with growth targets. This approach links strategic capacity planning to operational execution, ensuring quarterly goals reflect realistic delivery capacity rather than aspirational targets.

Final thoughts

Capacity planning ensures that strategy translates into delivery, aligning commitments with resource capacity to improve reliability. Treating it as an ongoing discipline links growth, roadmaps, and execution, enabling clear workload management and proactive trade-offs. Consistent capacity evaluation and data-driven strategies foster sustainable velocity, balanced workloads, and credible commitments over time.

Frequently asked questions

Q1. What are the 4 types of capacity planning?

The four main types of capacity planning are workforce capacity planning, project or team capacity planning, production capacity planning, and infrastructure or IT capacity planning. Workforce capacity planning focuses on people and skills, project capacity planning ensures initiatives fit within team capacity, production planning aligns output with demand, and infrastructure planning supports system scalability.

Q2. What is an example of capacity planning?

An example of capacity planning is calculating team capacity before a sprint. A five-person team planning a two-week sprint calculates available work hours, subtracts meetings and support time, applies a focus factor, and determines its effective delivery capacity. The team then selects backlog items that fit within that limit to ensure realistic sprint commitments.

Q3. What are the 4 types of planning in project management?

The four types of planning in project management are strategic planning, tactical planning, operational planning, and capacity planning. Strategic planning sets long-term goals, tactical planning aligns quarterly initiatives, operational planning manages day-to-day execution, and capacity planning ensures demand matches available resource capacity.

Q4. What are the 8 steps in the capacity planning process?

The 8 steps in the capacity planning process typically include forecasting demand, calculating gross capacity, subtracting non-project time, applying a focus factor, estimating effort, identifying constraints, adjusting commitments, and reviewing performance data regularly. These steps improve forecasting accuracy and workload balance across projects.

Q5. What are the 4 pillars of capacity?

The four pillars of capacity are time, skills, systems, and financial limits. Time represents available work hours, skills reflect expertise coverage, systems include tools and infrastructure, and financial limits define hiring and scaling boundaries. Effective capacity planning evaluates all four pillars together. When leaders quantify how much work fits into a quarter or sprint, trade-off discussions become data-driven.

Recommended for you

View all blogs
Plane

Every team, every use case, the right momentum

Hundreds of Jira, Linear, Asana, and ClickUp customers have rediscovered the joy of work. We’d love to help you do that, too.
Plane
Nacelle
